Monte Carlo Simulation

“House Construction”



Author:  Pat Dotson



Objective Hierarchies                                                Sensitivity Analysis

Variables and Attributes                                           Output Graph

Influence Diagram                                                     Implementation and Use





Objective Hierarchies

The objective of this project is determining the amount of time required to construct a new home using Monte Carlo Simulation. Monte Carlo Simulation is a mathematical technique for numerically solving differential equations. Monte Carlo Simulation is usually used to solve a problem that requires one or more statistics of a probability distribution be calculated. The Monte Carlo Simulation calculates multiple scenarios of a model by repeatedly sampling values from the probability distributions for the uncertain variables and using those values. The completion date of home is a necessary component for the home builder. The home builder needs the completion date for several reasons:

  • The customer purchasing the home wants a move in date that is specific.
  • The home builder needs a specific completion date to calculate the construction interest required for the new home.
  • The home builder knows how much working capital is tied up in each home and by having a specific completion date; the home builder will know the specific date when the working capital will be available for new projects.



Using Monte Carlo Simulation, the home builder will know within a certain probability level, the expected completion date of the new home.



Variables & Attributes



The following list is the variables required to compute the house completion date. For each work stage, the expected completion time is entered. The expected completion date is either days to complete as bid by the sub-contractor or the days to complete the work stage is based on previous experience constructing a house of similar size and features. The most optimistic days to complete work stage would reduce the expected by 15% and the pessimistic days to complete would be 40% greater than the expected days to complete. In house construction, it is typical that a project will take a higher percentage to run over the expected time than the percentage to reduce the completion time. To view the inputs for this model click on the following link:

Duration Model



Variable

Days to Complete Work Stage

Work Stages

Optimistic

Expected

Pessimistic

Plans

1.7

2

2.8

Site Plan Survey

3.4

4

5.6

Permits

3.4

4

5.6

Site Work

8.5

10

14

Foundation

5.95

7

9.8

Plumbing - Slab

2.55

3

4.2

Survey - Foundation

3.4

4

5.6

Waterproofing

0.85

1

1.4

Grading Backfill

1.7

2

2.8

Gravel Basement

0.85

1

1.4

Termite Protection

0.85

1

1.4

Basement Slab

2.55

3

4.2

Framing

8.5

10

14

Fireplace- Rough

0.85

1

1.4

Roofing/Shingles

1.7

2

2.8

Plumbing- Rough

3.4

4

5.6

HVAC - Rough

4.25

5

7

Exterior Trim/Siding

4.25

5

7

Windows & Doors

1.7

2

2.8

Steel-Brick

0.85

1

1.4

Electrical - Rough

2.55

3

4.2

Prime Exterior

0.85

1

1.4

Masonry

8.5

10

14

Security - Rough

0.85

1

1.4

General Site Cleanup

0.85

1

1.4

Insulation - Batts

0.85

1

1.4

 Sewer Line

2.55

3

4.2

Utility Connections

4.25

5

7

Brick Clean

0.85

1

1.4

Drywall

6.8

8

11.2

Water Line

0.85

1

1.4

Roofing -Flashing

0.85

1

1.4

Shutters

0.85

1

1.4

Grading - Final

1.7

2

2.8

Driveway

4.25

5

7

Guttering

1.7

2

2.8

Deck

0.85

1

1.4

Wrought Iron Railing

0.85

1

1.4

Fireplace -Final

0.85

1

1.4

Hardwood Flooring

1.7

2

2.8

Cabinets & Vanities

0.85

1

1.4

Interior Trim

4.25

5

7

Marble Tops

0.85

1

1.4

Ceramic Tile

1.7

2

2.8

Garage Doors

0.85

1

1.4

Painting - Exterior

1.7

2

2.8

Painting - Interior

4.25

5

7

HVAC - Final

1.7

2

2.8

Hardware - Interior

0.85

1

1.4

Clean - Windows

0.85

1

1.4

Plumbing - Final

1.7

2

2.8

Appliances

0.85

1

1.4

Light Fixtures

0.85

1

1.4

Electrical - Final

2.55

3

4.2

Security - Final

0.85

1

1.4

Insulation - Blown

0.85

1

1.4

Landscaping

2.55

3

4.2

Survey - Final

0.85

1

1.4

Wallpaper

1.7

2

2.8

Hardwood Flooring

3.4

4

5.6

Mirrors

0.85

1

1.4

Shower Enclosures

0.85

1

1.4

Flooring - Carpet

0.85

1

1.4

Flooring - Vinyl

0.85

1

1.4

Trim - Punch Outs

0.85

1

1.4

Cleanup - Pre-Final

0.85

1

1.4

Paint - Touch Ups

2.55

3

4.2

Power Wash Exterior

0.85

1

1.4

Clean - Final

0.85

1

1.4

Punch List Items

4.25

5

7





Influence Diagram



The influence diagram for this project is very intensive. Each activity or work stage in the process is connected to previous work stages. For example, the framing stage must be completed prior to starting of the roofing stage. To see the influence diagram for this project, click on the following link:

Critical Path for New Home Construction



:





Sensitivity Analysis

The following chart is a snap shot of the summary statistics for the simulation. The calculation to the right of each work stage represents whether or not the work stage is critical to the completion date of the house. If the results are a 1, then the work stage is said to always be critical, if the result is 0.501 as reflected in the Steel-Brick Stage, then the work stage is said to be critical 50.1% of the time. To view the simulation results of this model click on the following link: Simulation Results




Plans

1

Site Plan Survey

1

Permits

1

Site Work/Tree Removal

1

Foundation

1

Plumbing - Slab

0.013

Survey - Foundation

0.987

Waterproofing

0

Grading Backfill

1

Gravel Basement

1

Termite Protection

1

Basement Slab

1

Framing

1

Fireplace- Rough

0

Roofing/Shingles

0

Plumbing- Rough

1

HVAC - Rough

0

Exterior Trim/Siding

1

Windows & Doors

0

Steel-Brick

0.501

Electrical - Rough

0

Prime Exterior

0.503

Masonry

1

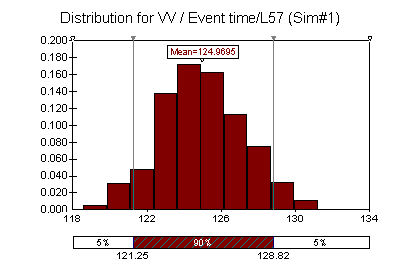

Output Graph

The following graph shows a histogram from simulation number one. One simulation was run for each work stage. The following output graph shows that the house can be completed between 121.25 and 128.82 days with a 90% confidence level.





Future Enhancements

This could use much improvement. In reality, most work stages can begin before their predecessor is completed. For example, the HVAC rough-in stage can begin two days after the plumbing work stage has begun. By starting before the previous stage has begun, the amount of days to complete the project would be greatly reduced. To improve this model, the expected start times must be implemented so that stages can start at their earliest possible date. The model must also consider external factors outside the control of the home builder. The weather is a variable that the builder cannot control. This variable needs to be implemented into the model to calculate the number of days to complete the house correctly.
